Project Selection
PV = FV / (1+r)n
|
FV = PV * (1+r)n
|
NPV = Pick the biggest number
|
ROI = Pick the biggest number
|
IRR = Pick the biggest number
|
Payback Period = Initial Investment / Cash Inflow per Period
|
BCR = Benefit / Cost
|
CBR = Cost / Benefit
|
Opportunity Cost = Value of project not being chosen
|
Communications
Communication Channels = n * (n -1) / 2
|
Numbers of conversations each person can have at any given point in time = n - 1
|
Procurement
PTA = ((Ceiling Price - Target Price) / Bayers Share Ratio) + Target Cost
|
|
|
Sinom
PV — Present value
|
FV — Future Value
|
r — Interest rate
|
n — Period of time
|
NPV — Net Present Value
|
ROI — Rate of Interest
|
IRR — Internal Rate of Return
|
BCR — Benefit Cost Ratio
|
CBR — Cost Benefit Ratio
|
PTA — Point of Total Assumption
|
EMV — Expected Monetary Value
|
P — Probability
|
I — Impact
|
EVM — Earned Value Management
|
CV — Cost Variance
|
SV — Schedule Variance
|
AC — Actual Cost
|
PV — Present Value
|
CPI — Cost Performance Index
|
SPI — Schedule Performance Index
|
EAC — Estimate at Complete
|
BAC — Budget at Complete
|
TCPI — To Complete Performance Index
|
ETC — Estimate To Complete
|
EV — Earned Value
|
VAC — Variance at Completion
|
C — Cumulative
|

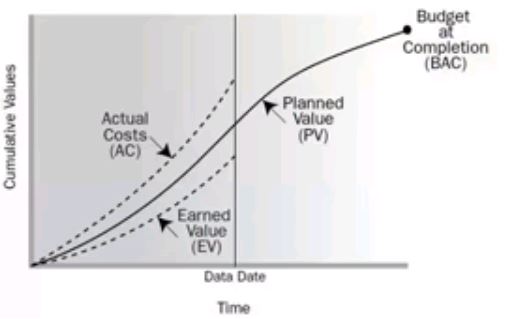

Cash flow, Cost baseline and Funding display
|
|
Earned Value Management (EVM)
EV = PV / AC
|
CV = EV - AC
|
SV = EV - PV
|
CPI = EV / AC
|
SPI = EV / PV
|
TCPI = ( BAC / EV ) / ( BAC / AC )
|
|
EAC = BAC / CPI no variances
|
EAC = AC + ETC with variances
|
EAC = AC + (BAC - EV) typical
|
EAC = AC + (BAC - EV) / CPI atypical
|
|
ETC = EAC - AC
|
VAC = BAC - EAC
|
|
CPI C = EV C / AC C
|
PV = FV / (1+r) n
|
Percent complete = ( EV / BAC ) * 100
|
|
